By Derrick Henderson, President of Lifestyle Design Homes and a Florida Certified Building Contractor with more than 20 years in construction across Southwest Florida. Updated September 2026.

Before you buy
14 checks
Survey to buildable area
Estates setbacks
75 / 30 / 75 ft
Front, side, rear, Collier County
Well and septic
$20K to $40K+
Where there are no utilities

Before you buy a lot in Southwest Florida, check fourteen things, and bring the builder in before you close. Building on your own lot starts with the land, not with the floor plan. The purchase price is only one part of the cost: a $30,000 homesite can need more site work than a $300,000 one that already has utilities, elevation, drainage, and access in place. This guide lists the checks, explains the ones that surprise buyers most, and shows what happens when you bring us a lot you already own.

In this guide

What should you check before buying a lot?

Fourteen things. Most of them can be checked before you make an offer, and a builder can check the rest in one site visit.

CheckWhat it tells youWhere to look
1. Lot dimensionsWidth, depth, and shape, which decide which plans can fitThe listing, then the survey
2. SurveyLegal boundaries, easements, and encroachmentsA current boundary survey by a licensed surveyor
3. Zoning and useWhether a single-family home is allowed, and the size and height limitsThe county zoning map and Land Development Code
4. Building setbacksHow far the home must sit from each lot lineThe zoning district table for the lot
5. Flood zone and required elevationHow high the finished floor must be, and how much fill that takesThe county flood map for the address
6. Utility availabilityWhether water, sewer, electric, and gas reach the lot, and how long the runs areThe utility providers for the address
7. Well and septic requirementsWhether the home needs its own water and wastewater systems, and which typeThe county and the Florida Department of Environmental Protection
8. Drainage and site conditionsStanding water, low spots, soil, and the fill the lot needsA site visit after heavy rain, and soil information
9. Wetlands and environmental conditionsAreas that may not be buildable at allThe survey, county maps, and an environmental review where they flag it
10. Protected speciesHabitat that can restrict clearing or add review timeThe same environmental review
11. Road and access conditionsWhether construction equipment and deliveries can reach the siteA site visit. Unpaved and private roads matter
12. HOA and community restrictionsArchitectural review, plan approval, and material rulesThe community documents, before you sign
13. Waterfront and seawall conditionsSeawall age and condition, and coastal construction rulesA seawall inspection and the county
14. Whether the home fitsThe buildable area left after setbacks, easements, septic, and drainageThe builder, with the plan drawn on the survey

Our main recommendation: involve the builder before you close on the land, whenever possible. Everything below explains why.

What makes a lot difficult or expensive to build on?

Thirteen conditions come up again and again in Southwest Florida. They fall into three groups.

Ground and water

Required elevation and fill. Flood zone requirements. Drainage and stormwater conditions. Poor or unusual soil. Wetlands and environmental restrictions.

Access and utilities

Clearing and vegetation. Access for construction equipment. Utility availability. Long utility runs. Well and septic requirements.

Rules and geometry

Setbacks and lot geometry. HOA or architectural restrictions. Waterfront and seawall conditions.

One of the biggest surprises for buyers is that two lots selling for similar prices can have very different development costs. There is no responsible single number for site work. A cleared infill lot with utilities at the street is a different project from land that needs fill, clearing, drainage work, and a long utility connection. That is why we evaluate the lot before we treat the construction price as the whole budget. Our guide to planning a custom home budget covers the other lines, including 2026 land prices in six cities.

How much of the lot can you build on?

Less than the lot size suggests. Setbacks are the minimum distances between the home and each lot line, and they are set by the zoning district. In Collier County’s Estates (E) district, which covers most of Golden Gate Estates, the Land Development Code requires 75 feet from the front lot line, 30 feet from each side, and 75 feet from the rear. The same table sets a minimum lot of 98,010 square feet, about 2.25 acres, a minimum width of 150 feet, and a maximum building height of 30 feet.

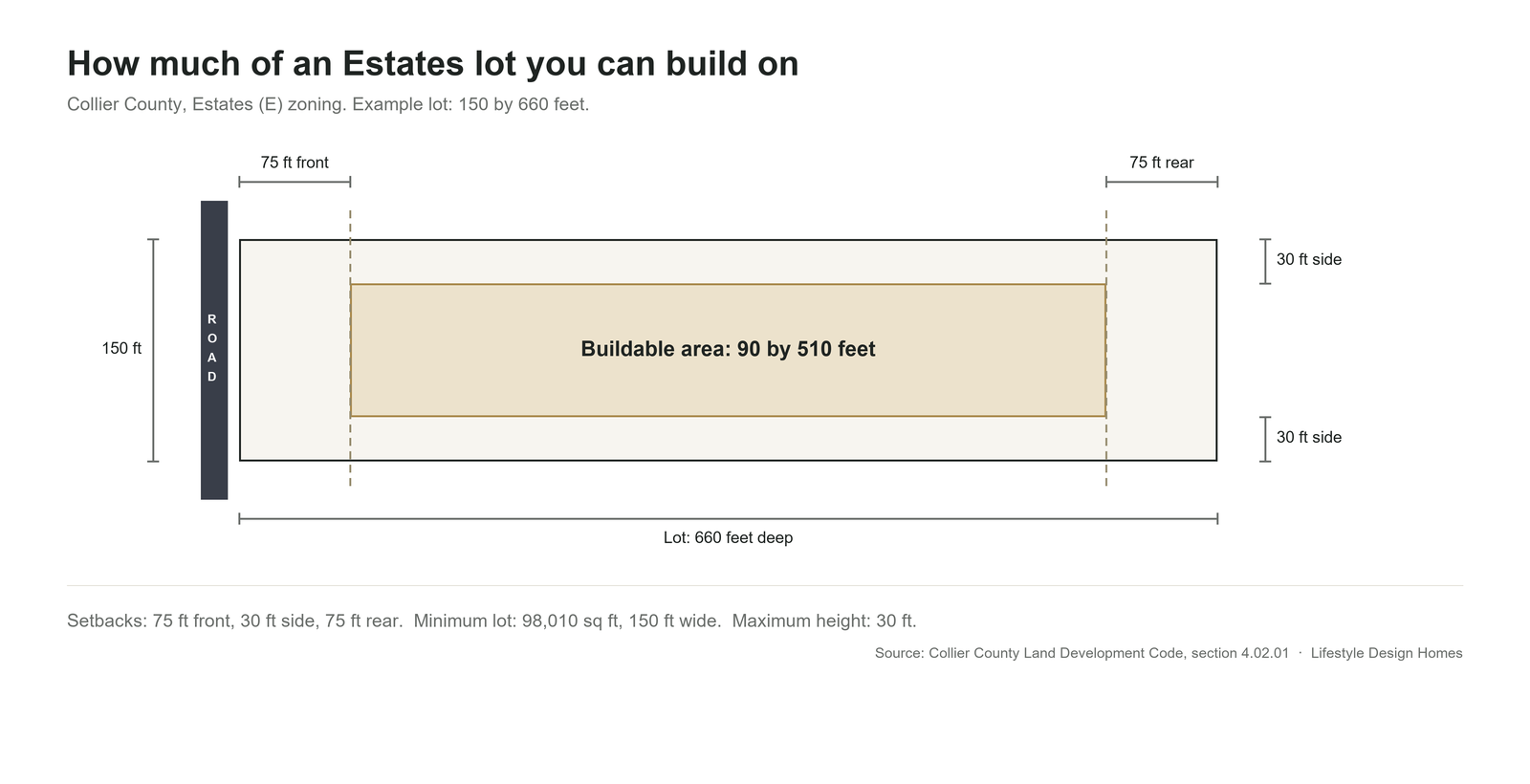

Plan view of a 150 by 660 foot Estates lot in Collier County showing the 75 foot front and rear setbacks, the 30 foot side setbacks, and the 90 by 510 foot buildable area

On a lot 150 feet wide and 660 feet deep, that leaves a buildable area 90 feet wide and 510 feet deep. Easements, the septic drain field, the well, drainage, and the pool all have to fit inside it too. Setbacks are measured from the legal boundary of the lot, not from easements, except where an easement is a road right-of-way.

Other districts use other numbers. RSF-3, one of Collier County’s single-family districts, requires 30 feet at the front, 7.5 feet at each side (10 feet on waterfront lots), and 25 feet at the rear. Lee County and the cities, including Naples, Marco Island, Bonita Springs, Estero, Fort Myers, and Cape Coral, have their own codes. Communities with architectural review add their own rules on top. We check the district for every lot before the first drawing.

What does the flood zone change?

The flood zone sets the elevation the finished floor has to reach. That elevation sets how much fill the lot needs, how the site drains, and on some lots the type of foundation. On many lots it is the item that changes the budget and the design most before any vertical construction begins.

In Collier County, you can look up the zone for an address on the county’s flood map. The county also keeps an elevation certificate map, where you can check whether a certificate is already on file for an existing structure. The certificate records the elevation of the structure and is prepared by a professional surveyor and mapper. The county’s Flood Information Hotline is (239) 252-2942. Lee County publishes its own flood maps, with new FEMA maps taking effect on March 2, 2027.

What surprises buyers from other states

How much the homesite itself shapes the design. Flood zone and elevation requirements, elevation certificates, wind engineering, impact-rated openings, drainage requirements, closer permitting scrutiny, stormwater rules, HOA architectural review, well and septic requirements in some areas, and salt air near the coast. In Southwest Florida these are not addressed after the floor plan is finished. They shape the home from the beginning.

Do you need a well and septic system?

Only where public water and sewer are not available. That is common in Golden Gate Estates, Lehigh Acres, Alva, Buckingham, and other larger-lot or rural areas of Southwest Florida. For planning purposes, expect a well and septic system together to add roughly $20,000 to $40,000 or more, depending on the property, the system design, the soil, and whether an enhanced treatment system is required.

Since July 2023, Florida law requires an enhanced nutrient-reducing septic system instead of a conventional one for new systems on lots of one acre or less inside designated Basin Management Action Plan areas, which include parts of Lee County. The Florida Department of Environmental Protection sets the permitting rules. These systems cost more and take more design work.

Both systems add time during pre-construction. They need their own design, permitting, site planning, and inspections, and the septic location has to be coordinated with the home, the pool, the driveway, drainage, setbacks, and the well before construction begins. They also need ongoing care: septic tanks need periodic pumping and inspection, and private wells need attention to water quality, filtration, and equipment. For our clients, we coordinate the monthly maintenance and service, so the systems are not left to the owner to manage.

What happens when you bring us a lot you already own?

We start with two things: what you want to build, and what the property allows. The process runs in seven steps.

  1. An initial consultation on the home, its size, the budget, the timeline, and your priorities.
  2. A review of the homesite: location, dimensions, access, orientation, utilities, setbacks, flood zone and elevation, drainage, and any known restrictions.
  3. Gathering or ordering the property information, starting with the survey.
  4. Deciding whether one of our plans fits the property or whether it needs modification or a custom design.
  5. Coordinating architecture, engineering, site considerations, and a preliminary budget.
  6. Identifying anything that could materially affect feasibility or cost, before you get too far into design.
  7. Formal pre-construction, design, permitting, and construction.

The question is not only whether a house fits. It is whether the right home for you can be built responsibly on that site.

Have we ever told someone not to buy a lot?

Yes. We have advised prospective clients against purchasing property when the lot conditions, the required improvements, or the overall economics did not make sense for what they were trying to build.

“We have had clients bring us properties they were considering purchasing because the price of the land looked like a great deal. Once we evaluated the property from a construction standpoint, there were site conditions that could have created significant additional costs to make the lot buildable.”

Derrick Henderson, President

Many buyers rely on their Realtor when searching for land, and a strong Realtor is an important part of the process. Evaluating whether a property is suitable for construction is a different skill. Setbacks, elevation, flood requirements, utilities, drainage, access, fill, permitting, and site development costs all decide whether a lot is a good fit. We work alongside the Realtor to review the properties you are considering, so the search moves toward land that supports the home, the budget, and the project.

We would rather advise you against a property than let you buy land that creates cost, limitations, or complications later.

What if the plan you love does not fit the lot?

It happens more often than people expect, and the answer is rarely to force the plan onto the land.

“I love the direction of the home, but I don’t want to force a house onto a lot that isn’t right for it. Let’s figure out what you love most about this plan and see whether we can adapt those elements to your property. If we can’t do that without compromising the home, then I’d rather tell you that now and help you find the right solution.”

Derrick Henderson, President

Our custom home floor plans are meant to be adapted to the lot. Whether a plan fits as drawn, needs modification, or calls for a custom design is one of the first things we settle. The land decides which changes make sense.

How do Collier County and Lee County differ?

Both require careful pre-construction planning, but permitting costs, impact fees, review processes, utility conditions, municipality requirements, and processing times vary by jurisdiction. Collier County projects, particularly inside Naples-area communities, may also involve community architectural review or design requirements. Lee County varies by municipality and by whether the property uses municipal utilities or well and septic.

Impact fees are one example. As of May 1, 2026, Collier County charges $34,051.97 for a single-family home under 4,000 square feet of living area, including county water and sewer. Lee County and the cities publish their own schedules. We confirm the figure for the specific address during pre-construction.

Where do we build on your lot?

Across Southwest Florida: Naples and Golden Gate Estates, Marco Island, Bonita Springs, Estero, Fort Myers, Lehigh Acres, Alva, and Buckingham. See where we build across Southwest Florida for how each area differs in lot size, utilities, and review process, and our custom homes in Naples page for how the design-build process runs on your lot.

If you do not own land yet, land and financing can be handled in the same conversation. Our guide to construction loans in Florida explains how. And if timing matters more than the search, we keep permitted homes on lots we already own. They are tagged Ready to Build on our available homes page.

Frequently asked questions

Should I buy the lot before choosing a builder?

Ideally, no. Bring the builder in before you close, or as early in the search as possible. A builder can tell you what a specific lot will cost to build on and whether the home you want fits the buildable area. We work alongside your Realtor on this, and we have advised clients against lots that did not make sense for what they wanted to build.

Can any lot be built on?

Not at a reasonable cost. Wetlands, protected species habitat, poor access, long utility runs, and elevation requirements can make a lot far more expensive than its price suggests, and some conditions rule a lot out entirely. Two lots that sell for similar prices can have very different development costs.

What are the setbacks in Golden Gate Estates?

Most of Golden Gate Estates is zoned Estates (E) in Collier County. The Land Development Code requires a minimum of 75 feet from the front lot line, 30 feet from each side, and 75 feet from the rear. The district also sets a minimum lot of 98,010 square feet, a minimum width of 150 feet, and a maximum building height of 30 feet.

How do I find the flood zone for a lot in Collier County?

Look up the address on the county’s flood map at collier.gov/floodmap. The county’s elevation certificate map shows whether a certificate is already on file for an existing structure. The Flood Information Hotline is (239) 252-2942. In Lee County, use the county’s flood maps for the address.

Do I need a well and septic system?

Only where public water and sewer are not available, which is common in Golden Gate Estates, Lehigh Acres, Alva, Buckingham, and other larger-lot areas. Plan for roughly $20,000 to $40,000 or more for both systems, plus separate design, permitting, and inspections before construction.

How much does site work add to a project?

There is no responsible single number. A cleared infill lot with utilities at the street is a different project from land that needs fill, clearing, drainage work, a well and septic system, or a long utility connection. We evaluate the lot before we treat the construction price as the whole budget. Our guide to planning a custom home budget covers the other lines.

Does building on my own lot take longer?

It depends on the lot. A homesite with utilities, good elevation, and clean drainage does not add time. One that needs fill, a well and septic system, or extensive site work adds several weeks before construction starts. Our guide to how long it takes to build a custom home in Florida shows the full schedule.

Can you work with my Realtor?

Yes. A strong Realtor is an important part of the search. Evaluating whether a lot is suitable for construction is a different skill, so we review the properties you are considering from a builder’s perspective and share what we find with both of you.

Before you close on the land

Get the survey and the flood zone first. Check the setbacks and the utilities, and find out whether the lot needs a well and septic system. Then put the plan you want on the survey and see what is left. If you send us the address before you close, we will do that review with you.
